Reports and export

The takeoff report, its columns and grouping, project info and branding, the exports (marked-set PDF, Excel, CSV, JSON, RFQ workbooks), revisions and the open sheets.

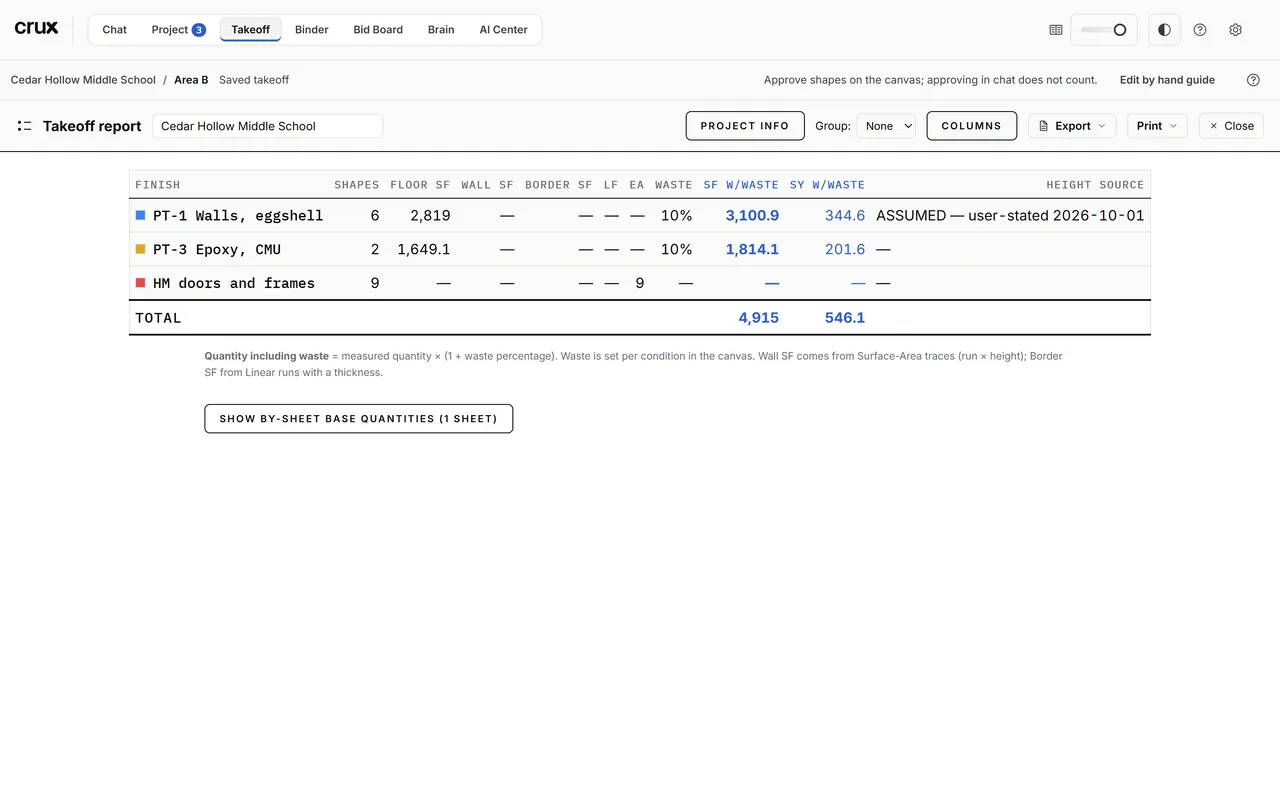

The takeoff report: each condition with its shapes, quantities, waste and w/Waste totals.The takeoff report: each condition with its shapes, quantities, waste and w/Waste totals.

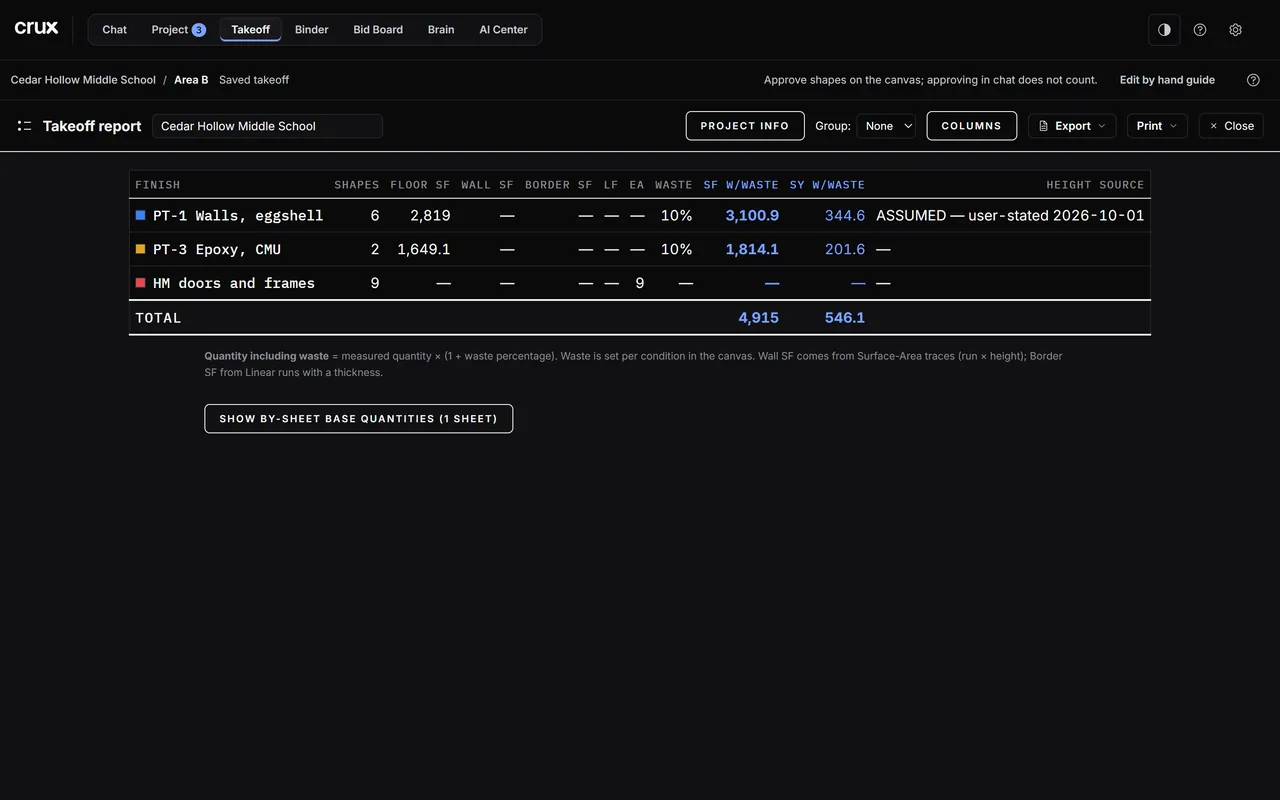

The takeoff report: each condition with its shapes, quantities, waste and w/Waste totals.

Open the report

Report · Export in the tool row (or ⋯ > Report · Export… in simple mode). One page for the whole takeoff:

  • one row per condition: shapes, Floor SF, Wall SF, Border SF, LF, EA, waste, SF and SY with waste, and the height source for walls (for example "user-stated 2026-10-01");
  • the buy list, which combines materials entered on conditions with material items crux derived from measured assemblies; entered quantities use the measured basis ÷ coverage and round up to whole units;
  • Show by-sheet base quantities for each sheet's numbers.

How the numbers work: waste lives only in the w/Waste columns (measured × (1 + waste %)); SY is SF w/Waste ÷ 9; a ×N multiplier multiplies every quantity; counts never take waste. Close goes back to the canvas.

Further down the report:

  • Materials — master buy list, grouped by Package or Category. A line that is not ready to order says why. Exceptions lists what needs a look: a material not in crux's materials catalog, two units for one material, a possible double buy, a material that comes out at zero. If crux's materials catalog cannot be reached, the buy list is held back rather than shown wrong; restart the crux app.
  • Installation-only scope: conditions with nothing to buy, in their own table.
  • Revisions noted: every markup on the sheets (type, sheet, note), so clouds and notes travel with the report.
  • Audit appendix: where each material quantity came from. For a derived assembly, it shows the formula and the measured inputs used. Show audit appendix opens it on screen; it always prints.

Columns, grouping and project info

  • Columns: what the table (and the CSV) shows. Optional columns include Total SF, Waste SF, Perimeter LF, your own condition columns, imported spec and Labor. When crux set paint details on a condition, a Paint group adds wall SF by height band (0-8 ft, 8-13 ft, 13-17 ft, 17-19 ft, 19-21 ft, over 21 ft), Substrate, Height Source and primer, finish and order gallons. Labor view shows the measured quantities with no waste (Total SF on, the w/Waste columns off); Reset goes back to the default columns.
  • Group: sections with subtotals by Sheet, by Label, by Pack group (when the job's pack groups its conditions) or by one of your columns.
  • Project name: the box at the top of the report; it names the export files.

Project info

Project info at the top of the report sets what prints on the report and the marked-set cover:

PartWhat you set
CompanyOne or more trade names (Add, Delete), each with a name, address and logo (Choose logo…, any image). Kept on this computer for every job.
BrandingTick Trade name — brand as your company to put the chosen trade name on this project's report and marked set instead of crux's. With several trade names, pick which one.
Client / jobClient name and address, PO or reference, and a date (for example Bid 7/12). Saved with this project.

Done closes it.

Export

Export in the report:

ExportWhat you get
Marked set PDFEvery sheet with takeoffs or markups, the work drawn on it in the conditions' colours with quantity chips, a legend cover with totals, approval seals and RFI markers. Include markups turns the markups on or off (seals always print). Send it to anyone; they need no software.
ExcelA workbook: Summary, By sheet, Materials, Shapes (the audit trail) and By floor × room.
CSVThe condition table, exactly the columns shown.
JSONThe full report as data.
Shapes CSV / JSONEvery shape's own measured quantity, no waste or multiplier.
Materials summary CSV / ExcelThe combined buy list.
RFQ workbooks (per package)One Excel file per supplier package, ready to send for pricing, with crux's working notes taken out. Lines that are not ready to order are set aside, not sent as priceable.

The three materials exports need crux's materials catalog; when it cannot be reached they are greyed out. Print prints the report itself. With RFIs on the canvas, RFI CSV and RFI JSON export the canvas's RFI register.

Takeoff exports go in the job's Takeoffs folder by default, including marked-set PDFs made in chat. If the job already has a Takeoff folder, crux keeps using it. The Save window starts there too. You can choose a different location. Marked-set PDFs and Excel takeoff reports saved there also appear under Files crux made.

The marked set follows the canvas: an inverted sheet prints dark.

Note: Your estimate does not come from this report. crux carries the approved takeoff into your estimate workbook itself (see Build the estimate); the report and exports are for checking and sharing.

Revisions

Revisions in the panels on the right edge. Addenda happen:

  • Save the takeoff as a named revision (Rev N and the date) at every bid revision and before anything risky.
  • Compare a revision with the live takeoff (Compare with current on its row) or pick any two in the Compare row (a baseline → another revision or the current takeoff): what moved, per condition, per sheet and on the buy list, with Export compare CSV. Unchanged conditions are hidden until you tick show unchanged.
  • Restore first saves the live takeoff as "Auto-backup before restore", then loads the revision.

Open sheets

N open in the tool row lists the sheets you opened from the gallery: jump to one, put it side by side with the current sheet, or close it. Closing a sheet never deletes its takeoffs.

Saving

The canvas saves the takeoff into the job's own folder about a second after every change; the status bar says saved. crux and the canvas share that file, so what you draw is what crux reads.

Common mistakes

  • Sending numbers without the drawings. The marked set is the takeoff: the quantities with where they were measured.
  • Comparing revisions to find which wall moved. Compare shows which numbers moved, by condition and sheet, not which line.
